Sampling for a new shoulder thread rarely takes a single round. Compatibility holds after a resin change routinely add weeks that Gantt charts omit. Ocean freight peaks before Q4 can absorb capacity even when production finishes on time.

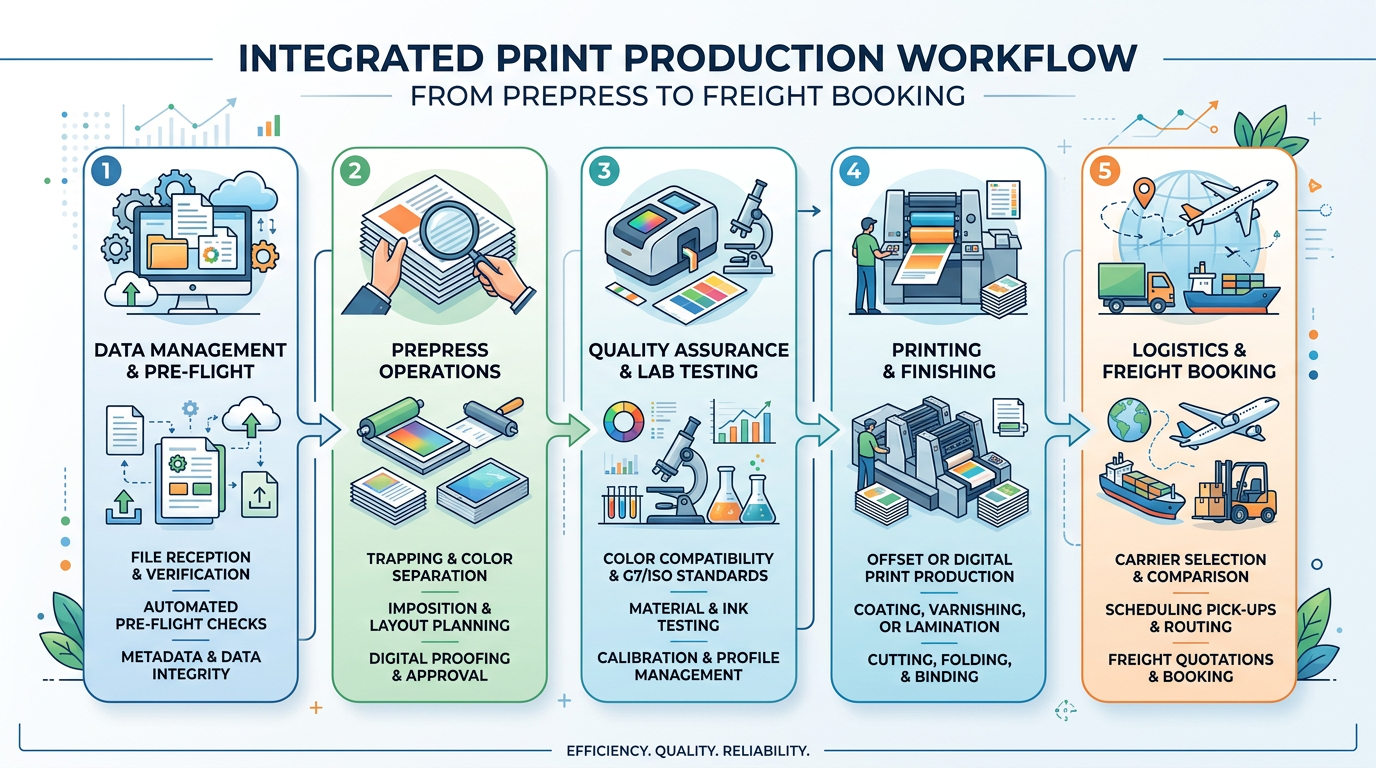

Run artwork prepress while the lab signs off resin. Book freight once weights stabilize within ten percent, not after the last cosmetic tweak. Keep alternate cap suppliers qualified so one mold repair does not freeze the program.

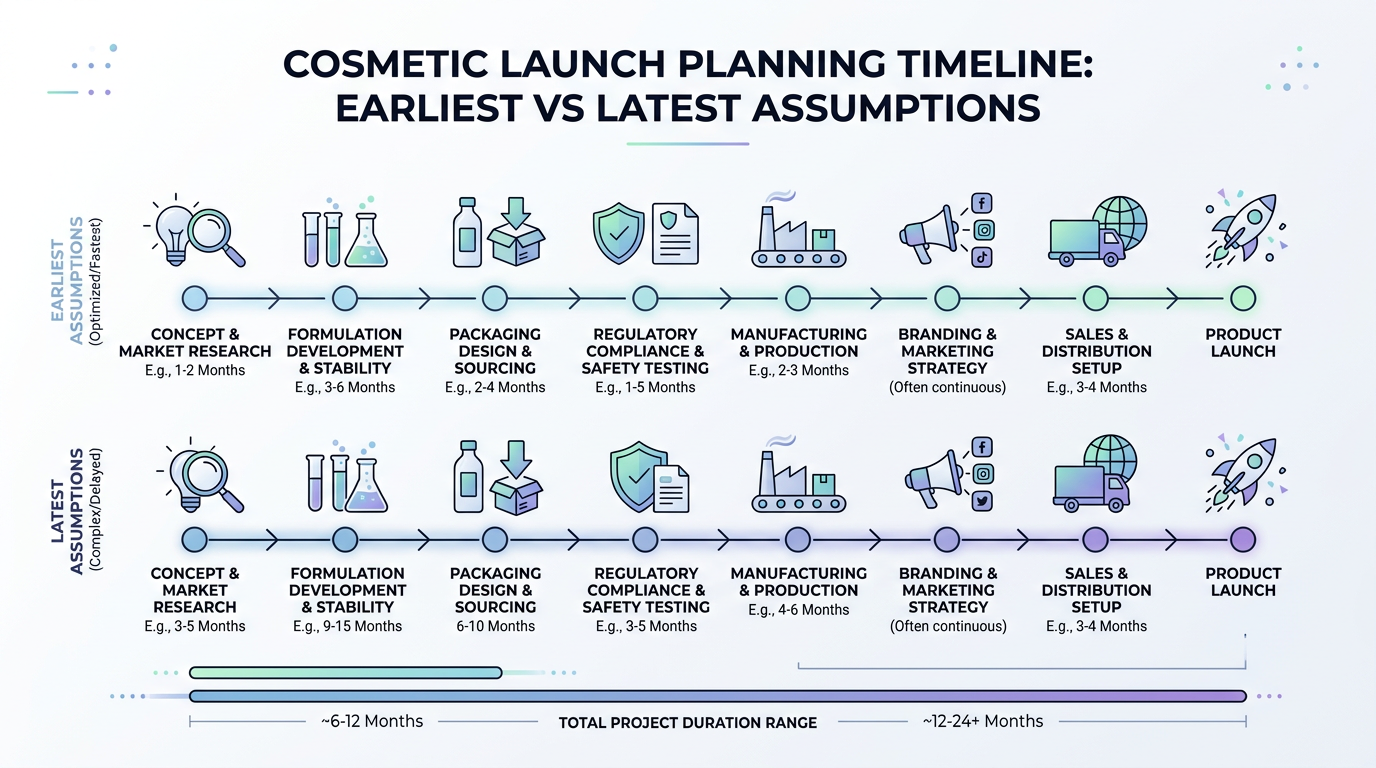

Share a range—earliest responsible date to latest with stated assumptions—rather than a single optimistic day. Operations teams make better decisions when uncertainty is visible.
Lead time is compatibility plus logistics, not machine hours alone. Document dependencies so marketing stops treating packaging like a print-on-demand sticker.
